Cross Hands
From Concept to Charge

Moreco originated the ultra-rapid EV charging scheme at Cross Hands — identifying and securing the site, driving the development process through trusted strategic partnerships, and enabling the delivery of operational EV infrastructure for E.ON Drive Infrastructure to strengthen coverage across the regional charging network.

Overview

Moreco completed the ultra-rapid EV charging scheme at Cross Hands in just 12 months — from site identification to energisation. The project delivered a strategically important solution for E.ON Energy, closing a critical network gap.

The project involved securing a suitable site, conducting early feasibility assessments, and carefully planning each stage to meet operational and technical requirements.

Planning

The planning process was carefully managed from the outset through early consultation and detailed pre-submission due diligence. Moreco and our delivery contractor engaged with Highways, Drainage and Flooding, alongside ecological consultants, at an early stage to identify and address key considerations prior to submission.

Given the project's location in Wales, the scheme was developed in line with Net Biodiversity Benefit (NBB) requirements, ensuring compliance with the relevant Welsh planning policy framework.

This proactive approach enabled a smooth and efficient planning process, with consent secured within 12 weeks and without conditions to discharge. As a result, construction commenced just 10 days following approval, removing potential programme delays and maintaining momentum through delivery.

Grid

Grid connections were arranged with the DNO, and detailed electrical designs were developed to ensure full compliance with network standards. Electrical works were carried out by Utility Line, with off-site connection works forming a critical part of the programme.

By anticipating statutory approvals and coordinating early with the local authority, potential delays were mitigated and progress on site was maintained throughout the programme.

Timelines were carefully coordinated with local authorities and key stakeholders, while close collaboration between civils contractors and an ICP enabled a seamless transition from concept through to build-out.

Delivery

Delivered through close coordination across multiple workstreams and third parties, the scheme required proactive communication to maintain programme certainty. Regular engagement between contractors, consultants, and stakeholders ensured activities stayed aligned and critical milestones were met without compromising safety or quality.

Energisation was achieved just 12 weeks after breaking ground. Moreco acted as the Principle Developer, working with specialist partners to deliver the scheme to specification and on schedule.

The outcome reflects the strength of the delivery team and the effectiveness of the collaborative approach, resulting in a timely handover to E.ON Drive Infrastructure, who now operate and manage the charging infrastructure. The site delivers safe, reliable, ultra-rapid charging to drivers day and night.

The site remains part of Moreco's portfolio, demonstrating the company's ability to manage complex, multi-stakeholder development programmes from identification through to operational handover.

Charger installation at Cross Hands — crane lifting Alpitronic 300kW unit into position during the 12-week build programme
Installation day — a crane lifts an Alpitronic 300kW charger unit into position. The 12-week on-site build programme commenced just 10 days after planning consent was granted.

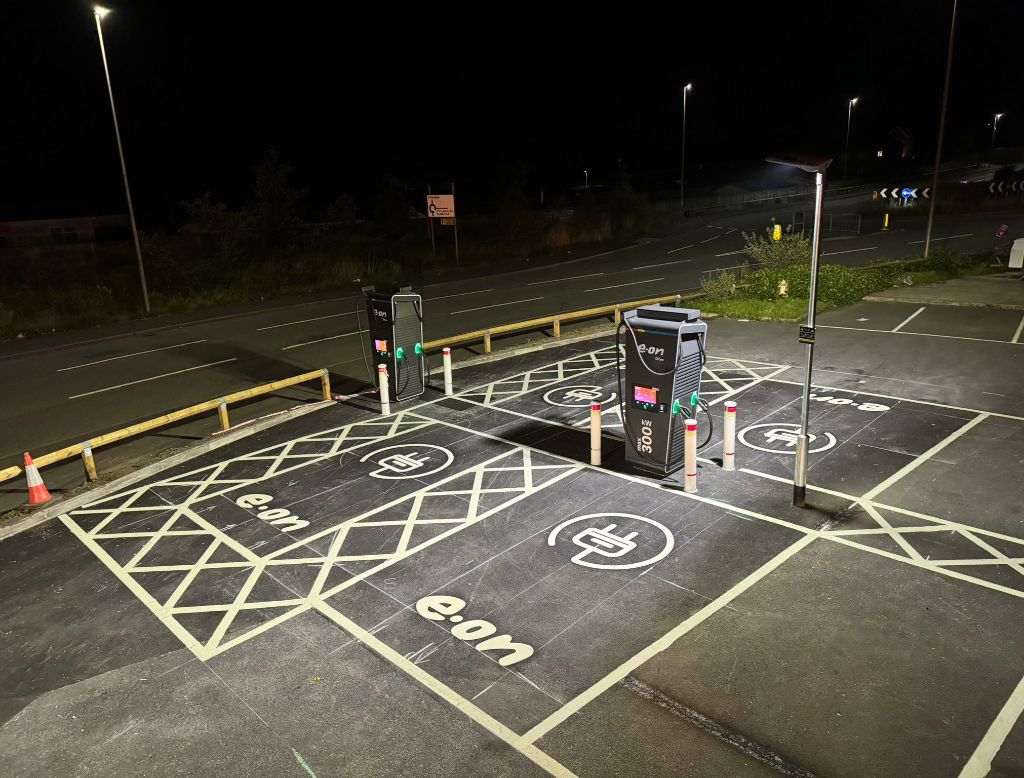

Cross Hands EV charging bays at night — e.on branded bay markings and 300kW Alpitronic chargers illuminated
The completed hub at night — e.on branded bay markings and Alpitronic 300kW chargers illuminated, operational and serving South Wales drivers around the clock.

Programme Timeline

1

Site Identification, Feasibility & Land Secured

Site identified in a critical network gap off the M4, en route to West Wales, within a retail park offering strong amenities. Early feasibility assessments undertaken and land secured to unlock the delivery pathway.

2

Planning Application Submitted

Application progressed through planning.

3

Detailed Electrical Design & DNO Approval

Secured, ensuring grid readiness ahead of mobilisation.

4

Planning Approval Achieved

Full planning consent secured within 12 weeks of submission.

5

Site Works Commence — 10 Days Post-Consent

Works mobilised on site within 10 days of planning approval.

6

12-Week Build Programme

Civils, electrical, and ICP works delivered in coordination with strategic partners.

Energisation — Site Live

Site energised and handover completed to the charge point operator, Edri/E.ON.

We're very pleased to share our positive experience working with Moreco, who in 2025 successfully delivered a rapid EV charging scheme in partnership with E.ON on our club's car park. From the outset, the project was handled with professionalism, care, and excellent communication.

The project was spearheaded by the Moreco team, who led the process from start to finish. They kept the committee fully informed throughout the planning and delivery stages and were always approachable, transparent, and solutions-focused.

The on-site works were completed safely, professionally, and within a tight timeframe — the entire build was delivered in just 10 weeks. We were kept updated throughout and any questions we raised were dealt with promptly and clearly. The finished installation looks excellent and has been very well received by our members and the local community.

We would have no hesitation in recommending Moreco to other landowners or organisations considering EV charging on their site. They delivered exactly what they promised — on time, on budget, and with minimal disruption to our club's operations.

Trustee, Cross Hands & District Working Men's Club

Cross Hands Social Club, South Wales · Landowner Partner

Verified

Have a similar site opportunity?

Whether you own land, operate an EV network, or run a business with adjoining vacant land — we'd like to hear from you.

Project Details

Status
Live · Operational
Location
Cross Hands, South Wales
Charging Bays
10
Charger Type
Alpitronic 300kW
Operator
E.ON
Development Time
12 months site ID to energisation
Build Programme
12 weeks on site
Electrical Partner
Utility Line
Moreco Role
Principal Developer
All case studies
